We are committed to maintaining and enhancing our infrastructure to deliver a high quality, safe and sustainable public transport network today and for future generations.
An effective and successful public transport network is vital for the economic, social, and environmental well-being of our society.
Planned works

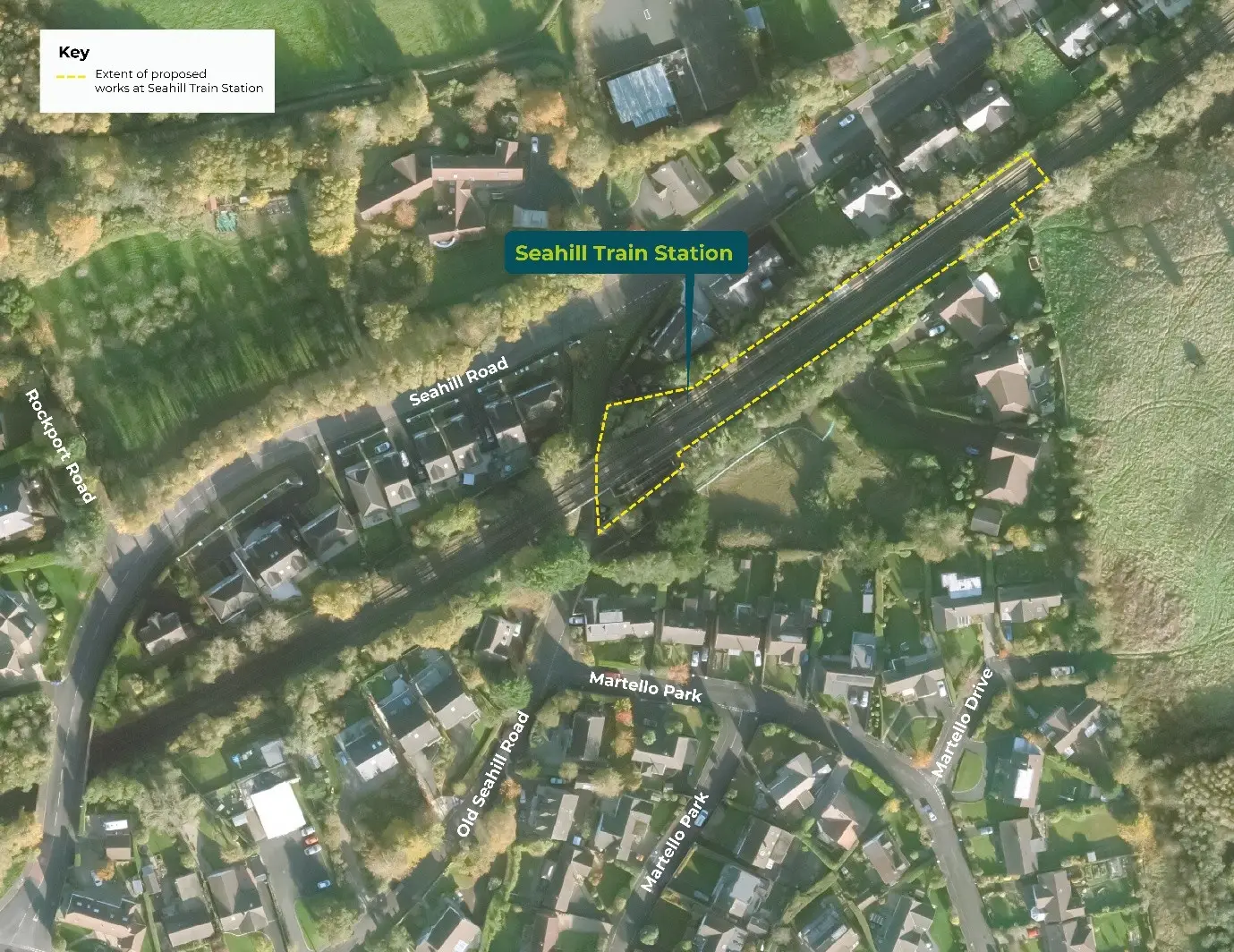

Seahill Train Station is located on the Belfast to Bangor railway line, and we will be undertaking essential maintenance works at Seahill Station to ensure the platforms and access areas remain safe and in good condition.
This project is essential to maintaining the safe and reliable operation of the station.
These works will be carried out by GRAHAM on our behalf, with the main period of works taking place during December 2026.
The project will include:
- Strengthening of the platform
- Upgrades to the access ramp
- Retaining wall reinforcement works
Progress update
Construction activity began in October with preparatory works on the station platform. This included platform demolition, removal of the existing shelters and installation of foundations ahead of the main construction programme.
Upcoming works
Upcoming sheet piling works
As part of the station construction programme, night-time sheet piling works will take place between 21 November and 29 November 2026. These works are required to construct the new platform infrastructure and involve specialist equipment operating overnight. Mobilisation ahead of these works has now commenced.
During this period, nearby residents may notice an increase in construction activity and associated noise.
The works will also require the temporary overnight closure of the underpass linking Old Seahill Road and Seahill Road between 9.30pm and 6.30am, together with a night-time road closure affecting three properties on Old Seahill Road. The affected properties have been contacted directly.
Ongoing construction works
Night-time construction activity will continue until 24 December 2026. While some noise is to be expected, the sheet piling works between 21 November and 29 November are expected to generate the highest levels of construction noise during the programme.
The Christmas line closure will be used to complete the proposed works as efficiently as possible and minimise the overall duration of construction activity. The line closure will run from after the last train on Thursday 24 December 2026 and will re-open before the first train on Monday 4 January 2027. No trains will operate on the Bangor line during this period.
All station works will be completed by 4 January 2027, at which point the station and railway line will re-open.
Compound site demobilisation will be completed during January 2027.
Key benefits of the project
- Protect the long-term future and sustainability of this asset on the important Bangor line rail corridor
- Maintain high safety standards for passengers and staff
- Reduce frequency of future maintenance and disruption to passengers
- Ensure the infrastructure remains fit for purpose for years to come
Area of works

Compound site establishment

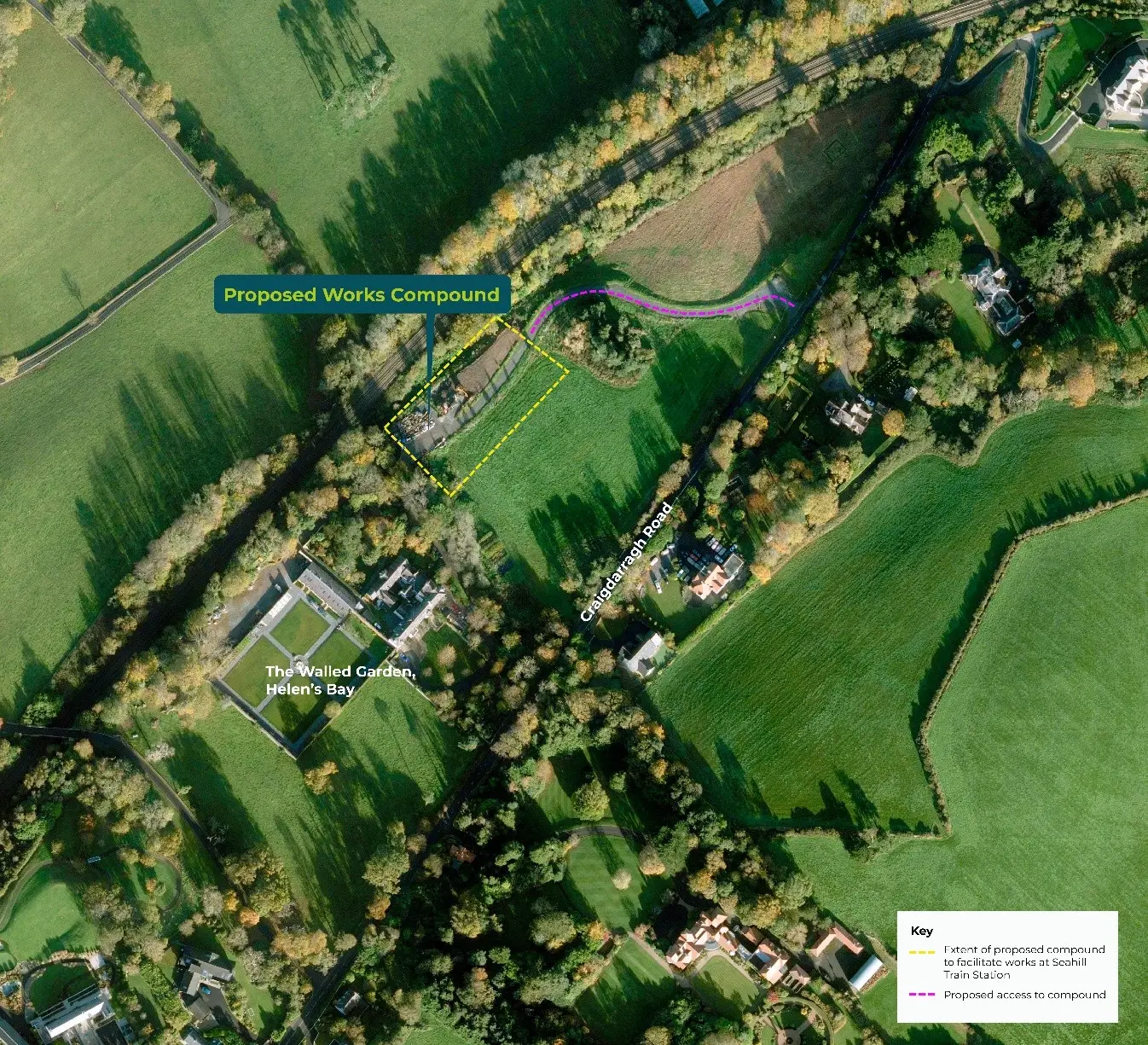

A temporary contractor compound is required adjacent to the Walled Garden, Helen’s Bay, BT19 1UB. This will be used for storage of project materials and equipment.
Establishment of this compound will commence during October 2026, with work completed during daytime hours. The compound site will be used until the completion of the project in January 2027.

Timeline of works
Detailed timeline of the work is set out below:
- Investigation work at the station was undertaken overnight on Saturday 12 September concluding on the morning of Sunday 13 September.
- Compound site construction began in October 2026.
- Partial demolition works and preparatory works began at the station platform in October 2026
- Road closure impacting three properties on Old Seahill Road 21 – 29 November.
- Initial night working ahead of the main works will begin 1 – 24 December 2026.
- Translink intend to utilise a Christmas line closure to complete the proposed works as efficiently as possible and minimise overall impact on local residents. The line closure will run from after the last train on Thursday 24 December 2026 and will re-open before the first train on Monday 4 January 2027, no trains will run on the Bangor line during this period.
- All works at the station will be complete by 4 January 2027 at which point the station and line will re-open, and the compound site will be demobilised.
Mitigation measures
GRAHAM will be undertaking the work on behalf of Translink. As experienced contractors GRAHAM will ensure mitigation measures will be in place throughout the project to minimise where possible impact on local residents and ensure work is taken forward in a sensitive manner.
Public event
A public information event was hosted on Wednesday 16 September 2026 in Glencraig Integrated Primary School. The event was well attended and gave local residents the opportunity to speak to members of the project team.
All information displayed during the event is available to view and download from the consultation project webpage.
Feedback
If you have any questions or cannot attend the public event, you can still view project information and request information in the following ways:
- Email: seahillproject@gravisplanning.com
- Phone: 028 9692 7258 – follow the instructions for Translink Seahill Project and leave a message.
- Post: Gravis Planning, 1 Pavilions Office Park, Kinnegar Drive, Holywood, BT18 9JQ.
